Skip to Content
Sinno Sdn Bhd
  • Home
  • Catalogue
  • Services
    • Stone Kitchen Countertops
    • Stone Wall Cladding
    • Stone Flooring
  • Gallery
    • Kitchen Countertops
    • Kitchen Island Tops
    • Kitchen Backsplash
    • Stone Wall Cladding
    • Bathroom Vanity Tops
    • Stone Table Tops
    • Stone Flooring
    • Custom Stone Projects
  • Blog
  • About Us
  • FAQ
  • 0
  • 0
  • Sign in
  • Contact Us
Sinno Sdn Bhd
  • 0
  • 0
    • Home
    • Catalogue
    • Services
      • Stone Kitchen Countertops
      • Stone Wall Cladding
      • Stone Flooring
    • Gallery
      • Kitchen Countertops
      • Kitchen Island Tops
      • Kitchen Backsplash
      • Stone Wall Cladding
      • Bathroom Vanity Tops
      • Stone Table Tops
      • Stone Flooring
      • Custom Stone Projects
    • Blog
    • About Us
    • FAQ
  • Sign in
  • Contact Us

Stone Countertop Lead Time in Malaysia - Why It Cannot Be Installed Tomorrow

Stone is cut to fit your kitchen, not pulled off a shelf. Here is where the lead time goes and how fast it can truly be.
  • All Blogs
  • Our blog
  • Stone Countertop Lead Time in Malaysia - Why It Cannot Be Installed Tomorrow
  • 28 September 2026 by
    Anson LowZF

    The lead time on a stone countertop in Malaysia exists because your countertop does not exist yet when you place the order. There is no warehouse of finished kitchen tops waiting to be collected. What exists is a raw slab, and turning that slab into a surface that fits your cabinets to the millimetre involves measuring your actual kitchen, cutting the stone on industrial machinery, profiling and polishing every exposed edge, then letting adhesive cure once it is in place. Every one of those steps has a fixed minimum time, and no amount of paying extra removes them.

    If you are mid-renovation in Kuala Lumpur or anywhere in the Klang Valley and your contractor has just told you the kitchen is ready, this is the part of the schedule most homeowners underestimate. Here is exactly where the time goes.

    Key Takeaways

    • Stone countertops are made to order, not stocked as finished pieces, so nothing can be delivered off the shelf.
    • Templating has to be done on site after your cabinets are installed and settled, which alone rules out same-week ordering and fitting.
    • In-stock material realistically takes within 7 working days from templating; special order material adds 21 to 28 days of shipping and customs before fabrication even begins.
    • Even in the best case, where cabinets are in, the sink and tap are bought and templating is already done, the workshop still needs roughly 2 to 4 working days to cut, mill, profile and polish.
    • A supplier who promises next-day installation is skipping templating, which is the single biggest predictor of a badly fitting countertop.

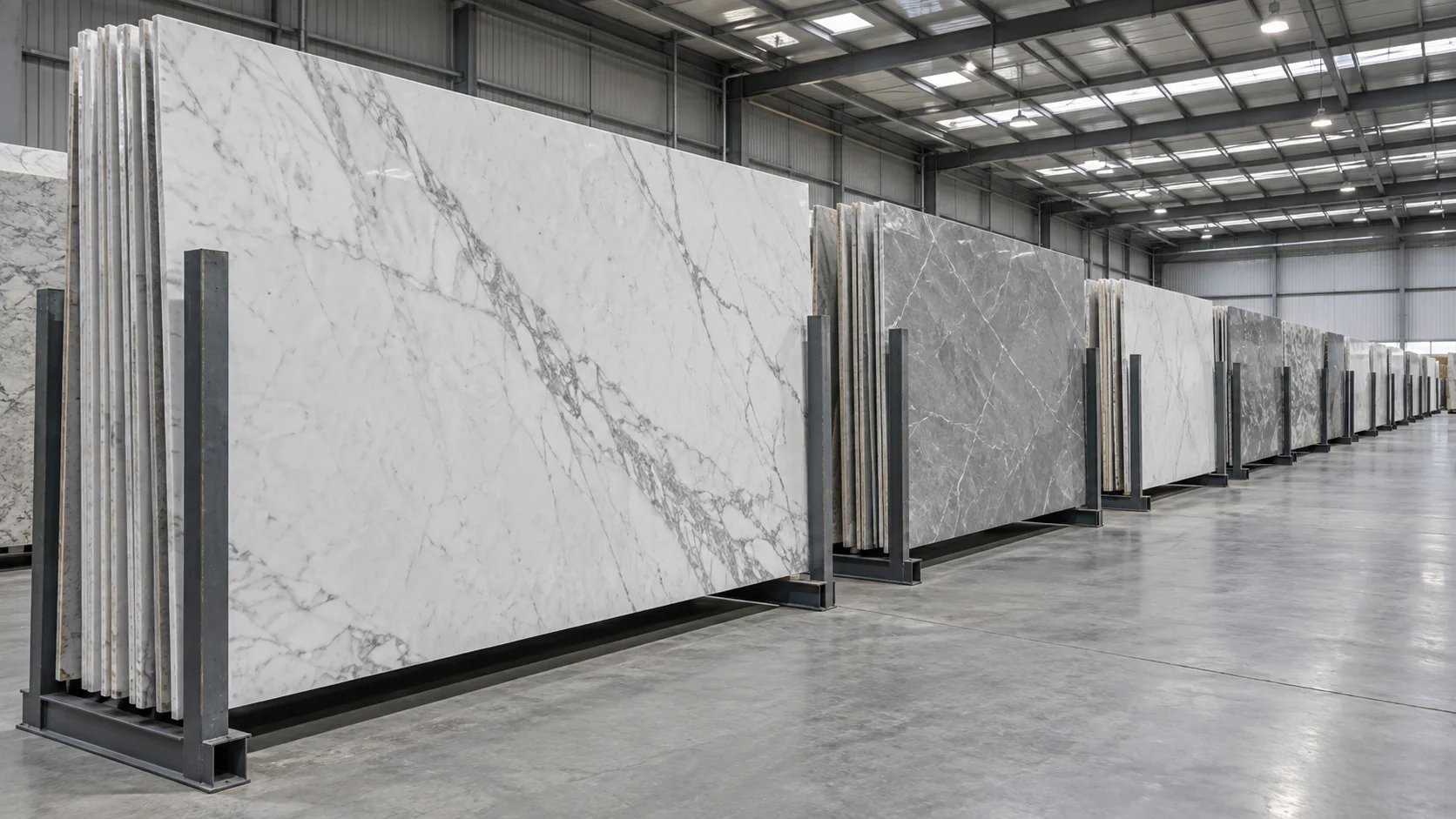

    Full-size quartz and sintered stone slabs stored upright in racks at a Malaysian stone warehouse before fabrication

    Why Can a Stone Countertop Not Be Installed the Next Day?

    Because a countertop is a made-to-measure product, not a stocked one. Think of the difference between buying a shirt off a rack and having one tailored. Both are shirts. Only one of them requires someone to measure your shoulders first, and no tailor can hand you a fitted shirt an hour after you walk in.

    What a stone supplier actually holds in stock is slabs. A slab is a large rectangle of quartz, sintered stone, porcelain or granite, typically stored upright in a warehouse rack. It has no sink hole, no hob opening, no finished edges, and no relationship to the shape of your kitchen. Between that slab and your finished kitchen top sit five separate stages, each performed by different people on different equipment.

    The other reason is more practical. Stone is unforgiving. A carpenter who cuts a wood panel 5mm short can pack it out or plane the next one. A fabricator who cuts a slab 5mm short has scrapped a piece of material worth several thousand ringgit and has to start again with a fresh slab, which pushes your timeline back by weeks rather than days. That risk is precisely why the process is deliberate instead of fast.

    What Has to Happen Before Anyone Can Cut Your Stone?

    Three things have to be locked down before a single cut is made: your cabinets, your measurements, and your appliance models. Miss any of them and the workshop cannot start.

    Your Cabinets Have to Be Installed and Settled

    Your countertop is cut to fit the exact footprint of your cabinet carcass, not the dimensions on a design drawing. Until those cabinets are physically in your kitchen and levelled, there is nothing accurate to measure.

    There is a Malaysian wrinkle here too. In our humidity, wooden cabinets shift slightly as they acclimatise after installation. Most fabricators wait three to five days after the carpenter finishes before sending a technician to measure. That wait is not padding, it is what stops you from getting a countertop with a visible gap along the wall. We cover the full sequencing in our guide on whether you need to install cabinets before ordering a stone countertop.

    Templating Has to Be Done on Site

    Templating is the measurement visit where a technician captures your kitchen down to the millimetre using a measuring tape and an L-shaped double-sided scale ruler. Corner angles, wall alignment, cutout positions, and every small irregularity in your walls get recorded.

    Malaysian homes, particularly older landed properties in areas like Petaling Jaya or Cheras, rarely have perfectly square corners. Templating exists to catch that. It produces the cutting plan the workshop works from, and it cannot be done remotely, in advance, or from a photo.

    Your Sink and Hob Models Have to Be Confirmed

    The CNC machine mills your sink and hob openings to the exact specification of the models you have chosen, including the slight inward angle on an undermount sink cutout. If you have not decided on your sink yet, the job sits on hold. This is one of the most common self-inflicted delays we see, and it costs homeowners days for no good reason.

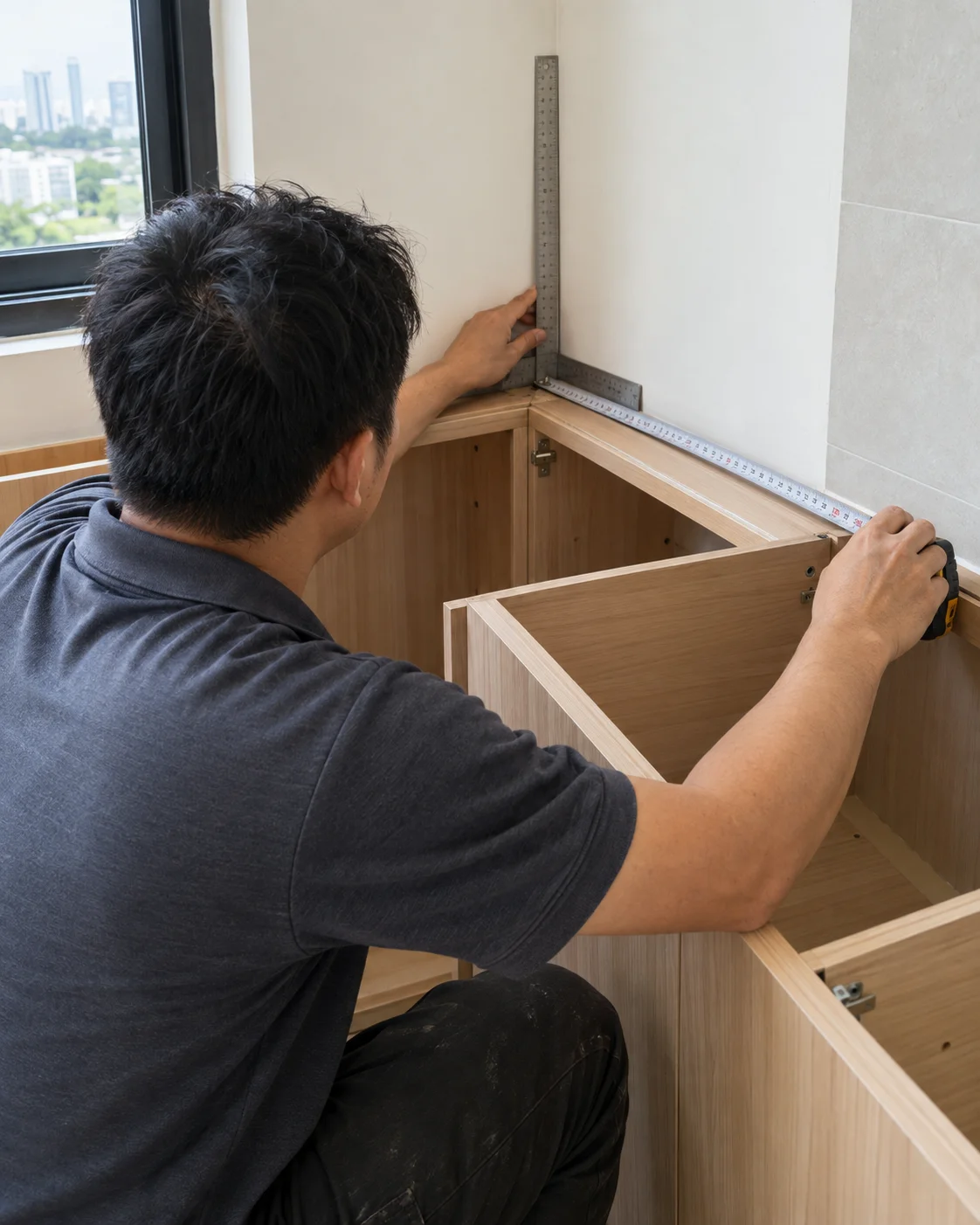

    Malaysian Chinese templating technician measuring installed kitchen cabinets with a tape and L-shaped scale ruler before a stone countertop is cut

    Is Your Slab Even in Malaysia Yet?

    This is the question that decides whether your project takes one week or six. If your chosen material is sitting in a local warehouse, the clock starts immediately. If it has to be shipped in, everything else waits.

    In-stock material covers the most widely held colours in Malaysia, which is why popular quartz ranges tend to move fastest. Order confirmation to completed installation typically runs within 7 working days, assuming your cabinets are ready.

    Special order material covers specific imported collections, whether that is a particular Caesarstone colour, a Silestone range, or a Dekton design. That journey takes 21 to 28 days and includes overseas shipping, arrival at port, customs clearance, and delivery to the fabrication facility. Only after all of that does the 7-day fabrication and installation window begin.

    Customs is the genuine wildcard. Clearance around major public holidays, whether Hari Raya, Chinese New Year or Deepavali, tends to slow down as import volumes spike and offices run shorter hours. If your move-in date is fixed, order early and build in a buffer rather than hoping for a clean run.

    One more thing worth confirming at the point of order: stock status changes. A colour you saw on a showroom rack last month may have been allocated to another job since. Always ask your supplier to confirm availability when you pay the deposit, not when you are browsing. For a fuller breakdown of the two scenarios, see our timeline guide on how long countertop installation takes in Malaysia.

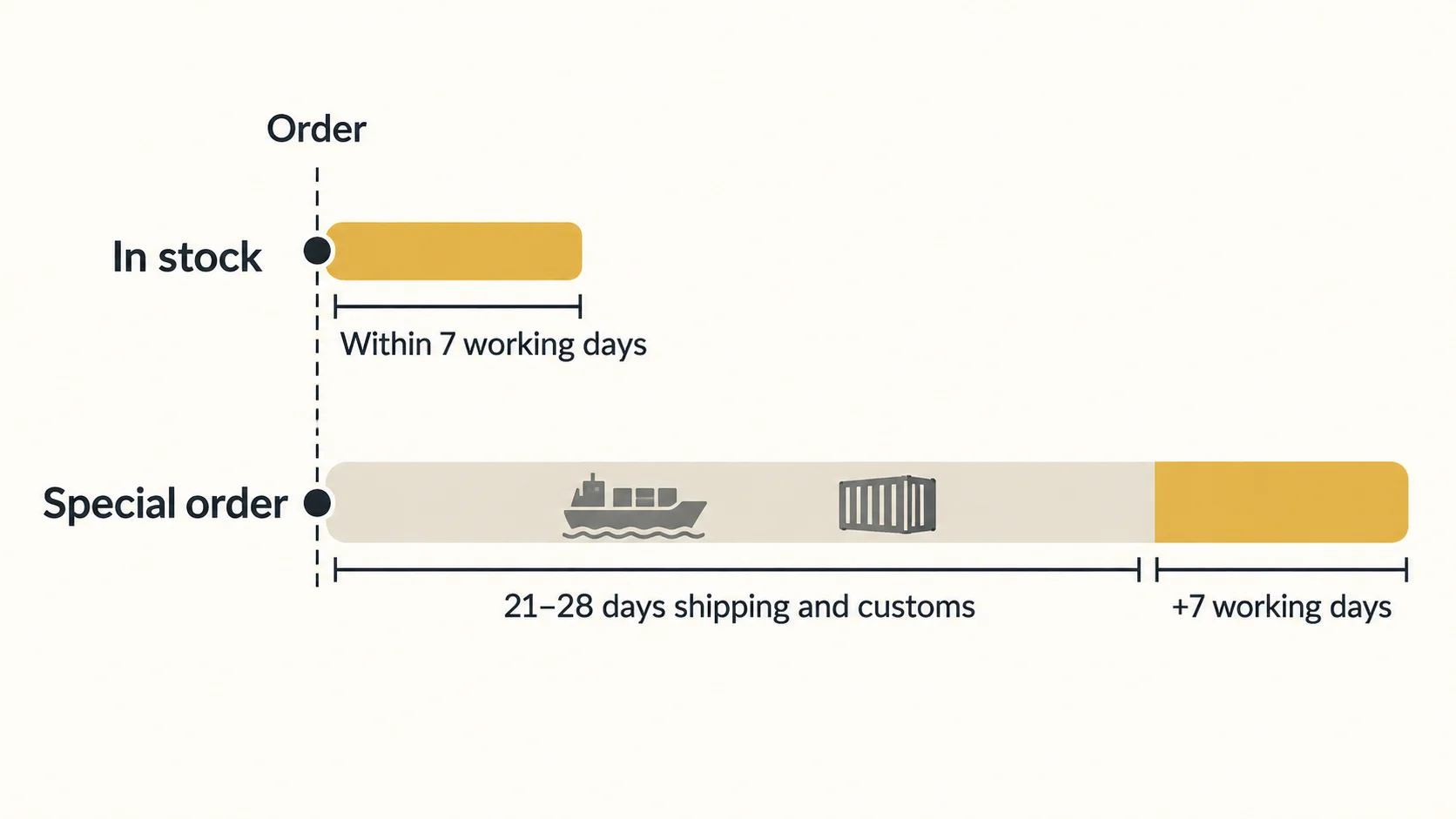

    Infographic comparing the in-stock countertop timeline of within 7 working days against a special order timeline of 21 to 28 days shipping plus 7 working days

    Why Can Fabrication Not Simply Be Rushed?

    Fabrication cannot be rushed because it is a sequence, not a single task, and each machine can only handle one piece at a time. Skipping ahead is not an option when the next stage depends on the previous one being finished and checked.

    Here is what your slab goes through after templating:

    1. Layout planning. The fabricator maps your cutting plan onto the actual slab, positioning pieces so veining runs consistently across your kitchen and seams land where they are least visible.
    2. Bridge saw cutting. The primary cuts that reduce a full slab to your countertop pieces.
    3. CNC milling. Sink openings, hob cutouts, tap holes and any curved shapes are milled to exact specification.
    4. Edge profiling. Every exposed edge is shaped, whether that is a simple pencil round, a bevel or a mitred waterfall.
    5. Surface finishing and quality control. Cutout edges are refined, the surface is checked, and the pieces are inspected before they leave the workshop.

    Material choice changes the pace. Quartz cuts smoothly and tolerates minor adjustment. Sintered stone demands slower cutting speeds and heavier water flow because of its hardness. Porcelain slab is the most demanding of the three, since aggressive cutting can cause delamination, so fabricators use specialist blades and take their time. If you have chosen sintered stone or porcelain, add a little to your fabrication expectation rather than assuming it matches quartz. Our walkthrough on how your kitchen countertop is made in Malaysia covers each stage in detail.

    Then there is the queue. A fabrication workshop is running other kitchens on the same bridge saw and the same CNC. Your job slots into a schedule alongside them. A supplier who claims they can jump you to the front of that queue overnight is either telling you something about their workload or about their process, and neither is reassuring.

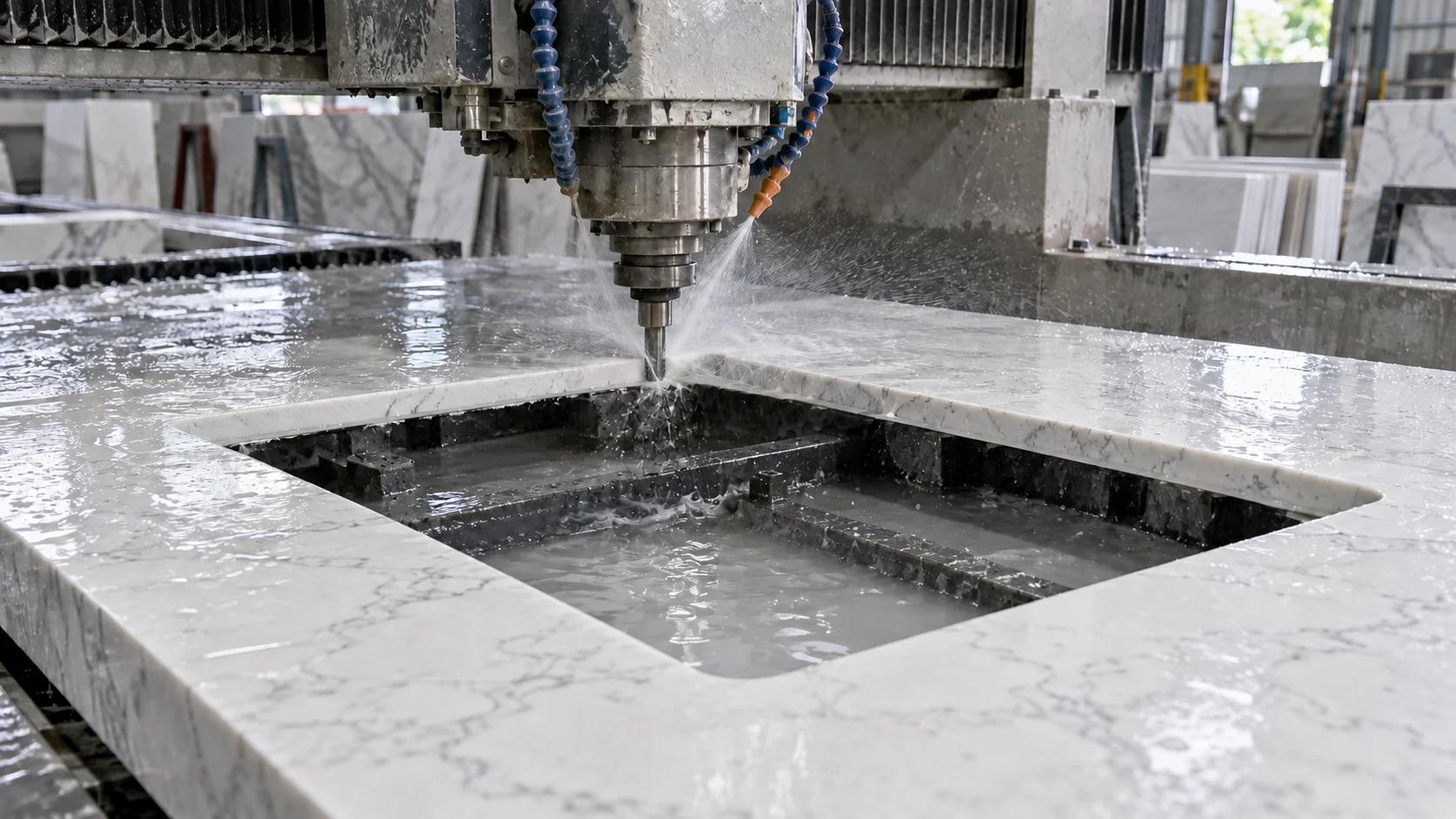

    CNC machine milling a precise undermount sink cutout into a white quartz countertop piece in a Malaysian fabrication workshop

    Does Installation Day Itself Need Time to Set?

    Yes. Even after your pieces arrive at your home, the last stage has a chemistry problem that no schedule can shorten.

    The installation team dry fits every piece first, placing it into position without adhesive to verify that the templating and fabrication were accurate. Once confirmed, silicone adhesive goes onto the cabinet tops and the pieces are lowered into their final position. For L-shaped kitchens or layouts with a separate island, sections are joined using marble adhesive colour-matched to the stone, then clamped whilst the adhesive cures. A good seam should be smooth to the touch and blend into the surrounding surface.

    After the stone is secured, the team connects the sink, seals around the cutouts with silicone, and checks the hob opening. In a Malaysian wet kitchen, where wok cooking and heavy spice prep mean constant splashing, that sealing work is what keeps moisture from getting behind the countertop over the years.

    The physical installation of a standard kitchen is a one-day job. What you cannot compress is the overnight cure before the surface goes into normal use. Adhesive sets at its own pace, and in our humidity it is not always the fastest pace either.

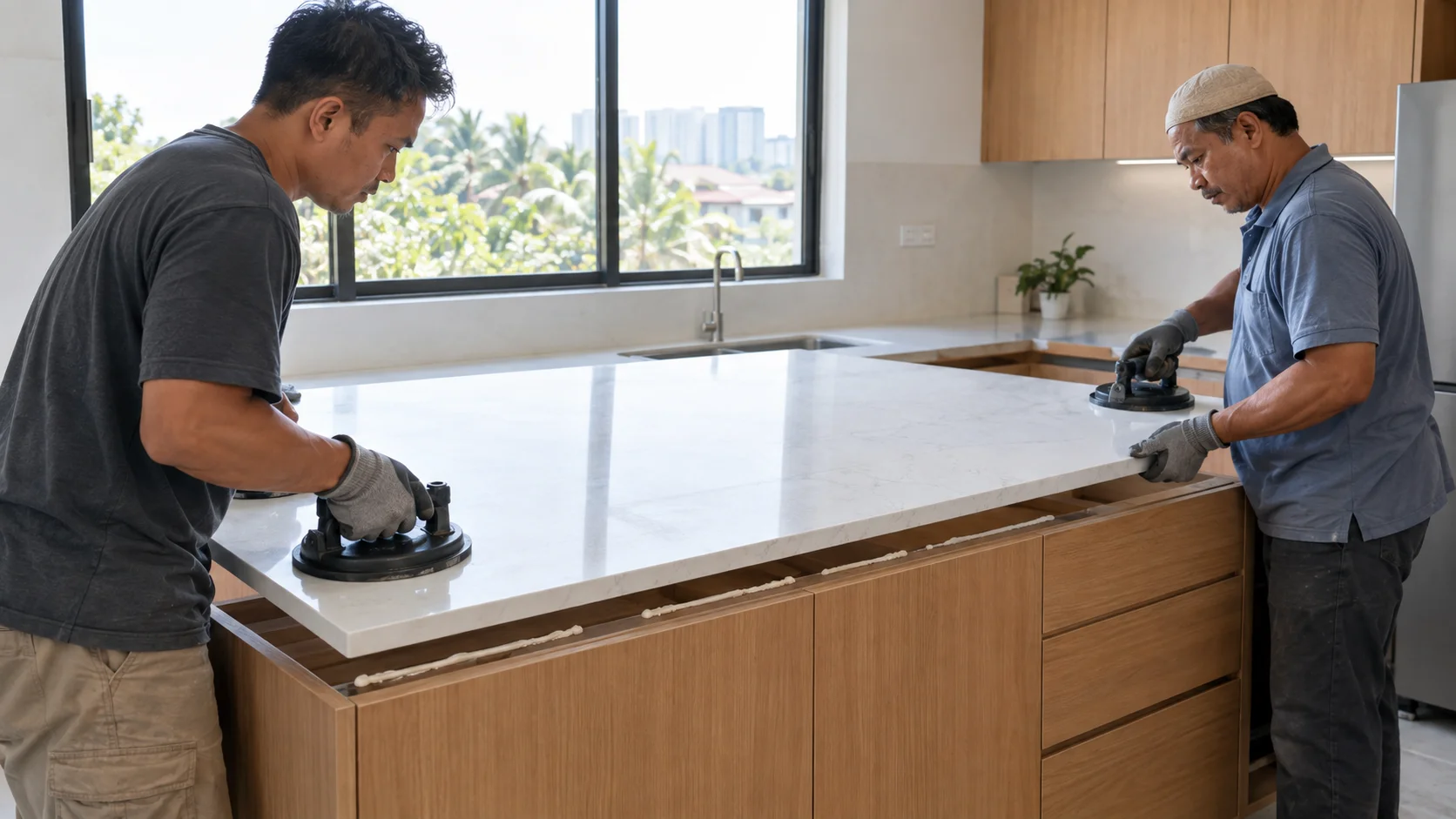

    Two Malay stone installers using vacuum suction lifters to lower a fabricated quartz countertop onto kitchen cabinets in a Malaysian home

    What If My Cabinets Are In, My Sink Is Bought and Templating Is Already Done?

    This is the fairest version of the question, and we get it often. The homeowner has genuinely done everything right. The carpenter has finished, the cabinets have settled, the sink and tap are sitting in their boxes in the living room, and our technician has already been to site and taken the template. Nothing is waiting on the client. So can they pay this afternoon and have the countertop installed tomorrow morning?

    Still no, but the gap is now days rather than weeks, and it is worth knowing exactly what those days are for.

    A template is not yet a cutting plan. The measurements our technician takes on site have to be drawn up into a shop drawing, checked against your cabinet layout, and then laid onto the actual slab. That layout step is where the fabricator decides where your seam falls, how the veining runs across a corner or an island, and how much material is left for the overhang. On a veined material this is a judgement call, not a formality, and most homeowners want to see and approve it before anything is cut. Skipping straight from a fresh site measurement to a running bridge saw is precisely how a seam ends up in the middle of your cooking zone.

    The slab still has to be pulled and confirmed. Stock moves. Between your selection and your payment, that particular slab may have been allocated to another job, or the remaining piece may be too small for your layout once the vein direction is taken into account. Confirming the physical slab is a real step, not paperwork.

    The machines still take their hours. Bridge saw cutting, CNC milling for your sink and hob openings, edge profiling and polishing, then surface finishing and quality control. Each of those runs on different equipment that is already scheduled with other kitchens. Even when everything goes cleanly, that sequence is realistically 2 to 4 working days, longer if you have chosen sintered stone or porcelain slab, which have to be cut more slowly.

    Installation needs a booked slot. The lorry, the suction lifters and a two or three man crew are scheduled in advance. Delivery of finished pieces is planned around the day's route, not squeezed in overnight.

    There is one more detail worth flagging. Having bought your sink and tap is genuinely helpful, but for an undermount sink many fabricators want the actual unit at the workshop, or at minimum the manufacturer's template and spec sheet, because the cutout is milled with a slight inward angle to match that specific bowl. Box in the living room helps nobody if it is still in the living room. Ask whether they need it dropped off, and confirm the tap hole diameter and position at the same time.

    So the honest answer for this client is that a well-run job with in-stock material, a completed template and a simple layout can move from payment to installed countertop in roughly 2 to 4 working days. That is a good outcome and it is largely because they did the sequencing right. It is just not tomorrow, and anybody who says it is has decided to cut before the drawing is done.

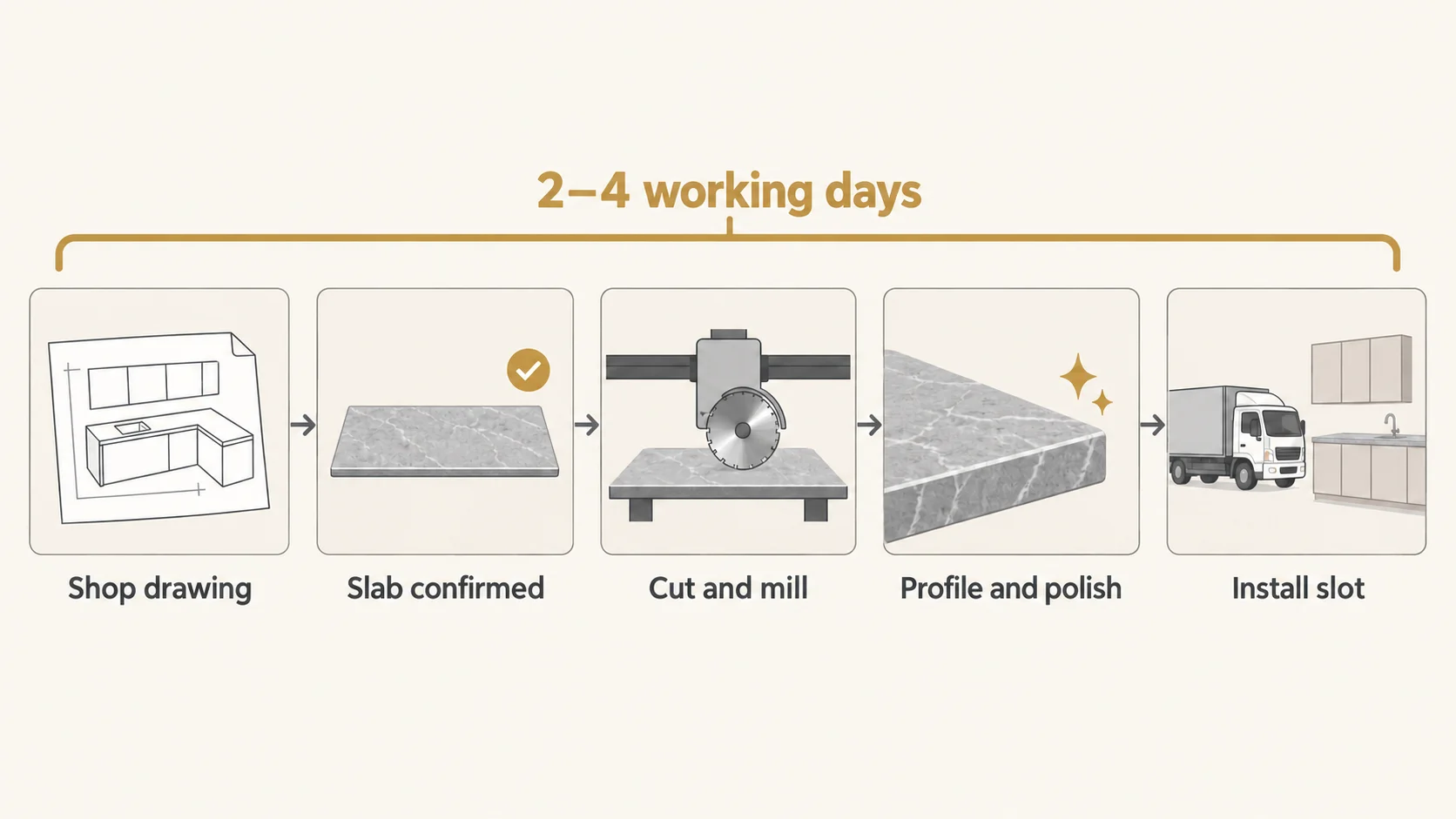

    Flat vector diagram showing the five steps between a completed template and an installed stone countertop, taking 2 to 4 working days

    What If a Supplier Promises You Next-Day Installation?

    Treat it as a warning, not a win. A next-day promise usually means one of a few things, and none of them ends well for your kitchen.

    • No templating. They intend to cut from your drawings or a rough site measurement. Expect gaps against the wall and a sink cutout that does not sit right.
    • Pre-cut standard sizes. Some operators keep pre-cut lengths in common widths and simply trim them on site. That works for a plain single run and fails for anything with a corner, an island or an undermount sink.
    • A different material than you think. Fast, cheap and always available is often the signature of compressed marble being presented as quartz. If the price and the speed both look too good, ask what the material actually is and get it in writing.
    • Offcuts. Small remnant pieces from other jobs, joined with more seams than your kitchen should have.

    Cartoon of a Malaysian Indian homeowner comparing a next-day countertop with a visible wall gap against a properly templated countertop that fits snugly

    If a quotation looks unusually quick, it is worth understanding what questions to ask before buying a countertop in Malaysia so you can tell a genuinely well-stocked supplier from one that is cutting corners. The same applies if you are thinking of buying a slab yourself and having a general contractor fit it, which we cover in whether you can ask your tiler to install quartz.

    So What Is the Fastest It Can Realistically Be Done?

    Here is the honest picture, assuming your cabinets are already in and settled.

    StageRealistic timeWhat decides it
    Material sourcing (in stock)Same day to 2 daysWhether your colour is held locally
    Material sourcing (special order)21 to 28 daysShipping, port arrival, customs clearance
    Templating visit1 to 2 days after order confirmationCabinet readiness and technician scheduling
    Fabrication and quality controlWithin the 7 working day windowMaterial type, kitchen complexity, workshop queue
    Installation1 dayNumber of pieces and seams
    Cure before normal useOvernightAdhesive, humidity

    In-stock material: within 7 working days from templating. Special order material: 21 to 28 days on top of that. If your template is already done, the remaining fabrication and installation window is realistically 2 to 4 working days.

    If your timeline is tight, three decisions genuinely move the needle:

    Choose from what is in stock. The single fastest lever you have. A well-stocked local colour removes the entire shipping and customs block from your schedule, and it is usually the most straightforward option on price too. Our 2026 guide to what a quality stone countertop costs in Malaysia shows where each brand sits, so you can weigh speed against budget in one go.

    Start selecting whilst your cabinets are still being built. Material selection and cabinet installation can run in parallel. Homeowners who wait until the carpenter is finished before visiting a showroom add weeks to their own project for no reason.

    Confirm your sink and hob before templating. Have the model numbers ready so the workshop can mill your cutouts without waiting on you.

    If you are still choosing a colour, do it from a full slab rather than a small chip, since batch variation is real. We explain why in our post on not choosing your countertop from a sample alone.

    FAQ

    Can I get a stone countertop installed in one day in Malaysia? The installation itself is a one-day job, but the process leading up to it is not. From order confirmation to a fitted countertop, expect within 7 working days for in-stock material and 21 to 28 days on top of that for special order material.

    Why do I need templating if I already have my kitchen drawings? Drawings show the design intent, not the built result. Cabinet positions shift slightly during installation, walls are rarely perfectly square, and a few millimetres of difference is enough to leave a visible gap or misalign a sink cutout. Templating measures what is actually there.

    My cabinets are done, I have bought my sink and tap, and templating is finished. Can I pay today and install tomorrow? Not tomorrow, but you are close. With those steps behind you and in-stock material, the remaining work is drawing up the cutting plan, confirming the slab, cutting, milling, edge profiling, polishing and quality control, then a booked installation slot. That realistically takes 2 to 4 working days from confirmation of order.

    Can I pay extra to get my countertop faster? Paying more does not remove shipping time, customs clearance, or the cure time for adhesive. What it can sometimes do is prioritise your slot in the fabrication queue, which might save a day or two. Ask your supplier honestly rather than assuming a rush fee buys a week.

    What happens if my renovation is delayed after I have already ordered the stone? Nothing is wasted. Your slab is reserved or already in the warehouse, and templating simply gets rescheduled once your cabinets are ready. This is exactly why ordering early carries no downside.

    Conclusion

    The reason you cannot order today and install tomorrow is the same reason your countertop fits properly in the first place. Every step that adds time also removes a way for the job to go wrong, from templating against your real cabinets to letting the seam adhesive cure before you put a wok down on it. Two weeks from cabinet completion to a finished countertop is a good outcome for in-stock material, and five to six weeks is normal if you have set your heart on something imported.

    Plan for it, order your material whilst the carpenter is still working, and you will never feel the wait. If you would like a straight answer on what is currently in stock and what your realistic dates look like, the team at Sinno Stone can walk you through the timeline before you commit to anything.

    in Our blog
    # Countertop Mistakes Homeowner Tips Kitchen Renovation Tips
    Share this post
    Labels
    Countertop Mistakes Homeowner Tips Kitchen Renovation Tips
    Our blogs
    • Case Studies
    • Our blog
    What Can You Use as a Base for a Vanity Stone Top? Metal Bracket, Metal Frame Box, Cement or Cabinet
    The base under your vanity top decides whether it lasts fifteen years or cracks in two.

    Subscribe to our newsletter

    Be the first to find out all the latest new, products and trends.

    Thanks for registering!

    Subscribe
    sintered stone countertop
    quartzite countertop
    Follow us

    Social Media

    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Click here to setup your social networks
    Credit Card Payment

    Sinno Sdn Bhd

    Since 2013, we've been Klang Valley's trusted stone countertop specialist, helping over 4,000+ families transform their kitchens with premium quartz, sintered stone, porcelain slab and natural stone solutions.

    ​  ​   ​

    Explore
    • Home
    • Catalogue
    • Services
    • Gallery
    • Blog
    • About Us
    • Contact Us
    • For Interior Designer
    Resources
    • Care & Maintenance
    • Warranty
    • Privacy Policy
    • Careers
    Chat with us
    Stones
    • Quartz Stone
    • Sintered Stone
    • Granite
    • Quartzite
    • Terrazzo
    • Marble
    2013 - 2026, Sinno Sdn. Bhd. (1483172-D) All Rights Reserved ©
